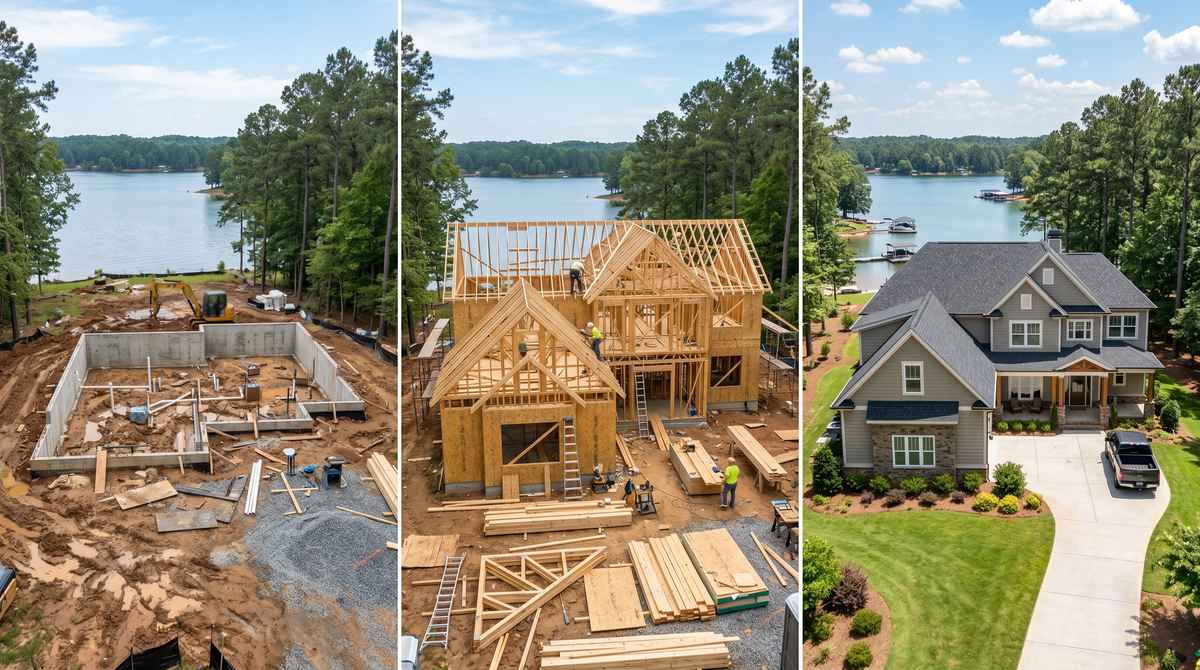

“How long will this take?” is the second-most-asked question we hear, right after cost. The honest answer for a custom home in Lake Wylie, SC is 10 to 14 months from contract to keys for a typical 2,800–4,000 sq ft build on a clean lot.
But that top-line number hides a lot of reality — permit delays, Duke Shoreline approvals, material lead times, and Carolina weather all move the schedule around. This article walks through the full timeline phase by phase so you can plan your move, your existing-home sale, and your life around actual construction milestones. For the current-year version of these numbers, see our realistic 2026 build timeline for Lake Wylie, which reflects this year's permit and material lead-time conditions.
What Is the Honest Baseline Timeline: 10–14 Months?
Most Lake Wylie custom homes take 10 to 14 months from contract signing to move-in, with our average delivery landing around 11.5 months from notice-to-proceed to certificate of occupancy. That range assumes a clean lot, finalized plans before permitting starts, and no major waterfront or HOA complications.
Our average Lake Wylie custom home delivers in 11.5 months from notice-to-proceed to certificate of occupancy. That baseline assumes:
- Plans are final and engineered before we start permitting.
- Lot is already purchased and clear-titled.
- No waterfront Duke Energy permit needed (add 6–10 weeks if so).
- No major HOA architectural review delays.
- Normal weather year (1–2 weeks of rain/weather loss is baked in).
Larger homes, lakefront projects, and complicated lots regularly run 14–18 months. Production builds are faster because plans and specs are already dialed; custom is slower because you’re designing one-of-one.
It helps to compare this against what national data shows for owner-built and contractor-built custom homes. The U.S. Census Bureau's Survey of Construction has historically put the national average for contractor-built single-family homes at roughly 8 to 10 months of pure construction time, not counting pre-construction design and permitting. Lake Wylie's timeline runs longer than that national average primarily because of the added HOA architectural review layer present in most of the area's waterfront and golf communities, plus the Duke Energy Shoreline permit that applies to any lot touching the lake. Homeowners moving from other parts of the country are sometimes surprised that a market with a relatively fast local building department can still take longer overall once these additional approval layers are factored in.
What Happens During Phase 1: Pre-Construction (Months 1–2)?
Pre-construction is where design, budgeting, financing, and HOA approval come together before any dirt moves, and it is the single biggest source of both delay and savings on the overall timeline. Clients who finalize plans, specs, and financing before groundbreaking consistently finish faster than those still making decisions once construction starts.
This is where most timeline risk lives — and where most clients underestimate the effort. Pre-construction includes:
- Design development: Converting concept sketches into buildable, engineered plans. 4–8 weeks.
- Specifications and allowances: Nailing down finish schedules for every room. 2–3 weeks, often concurrent with plans.
- Estimating and contract: Final bid, contract review, contract signature. 1–2 weeks.
- Construction loan closing: 3–6 weeks from application if you’re financing. Start this early.
- HOA architectural review: 2–6 weeks depending on the Lake Wylie neighborhood.
We strongly recommend a full pre-construction consultation before signing anything. Decisions you make here — framing specs, mechanical systems, window packages — lock in cost and timeline for the next 12 months.
What Happens During Phase 2: Permitting (Months 2–3)?
Permitting for a Lake Wylie custom home typically involves the York County building permit, a septic permit if the lot is not on sewer, an HOA architectural review, and a Duke Energy Shoreline permit for waterfront lots. These approvals can run partly in parallel, but none of them can start until the plans are truly final.
Lake Wylie custom homes typically need three separate approvals:
- York County SC building permit: 4–8 weeks. York County’s Planning & Development Services office reviews the plans, septic approval, and zoning compliance.
- Septic permit (if non-sewer): Perc test and system design, typically 3–5 weeks, done in parallel.
- Duke Energy Shoreline permit: 6–10 weeks, required only for waterfront work affecting the lake.
- HOA ARC approval: 2–6 weeks, depending on neighborhood (River Hills, The Palisades, Handsmill, etc.).
We run these approvals in parallel whenever possible, but they can’t all start until plans are final. That’s why pre-construction discipline pays off — a plan change at month 3 restarts the permit clock.
AEO Quick Recap: Pre-Construction + Permits
- Pre-construction: 6–10 weeks typical.
- York County building permit: 4–8 weeks.
- Duke Shoreline (waterfront only): 6–10 weeks.
- HOA review: 2–6 weeks, runs in parallel.
What Happens During Phase 3: Site Work and Foundation (Months 3–5)?
Site work and foundation covers clearing, grading, footer excavation, and the foundation pour, typically running 5 to 7 weeks once permits are in hand. Wet Carolina springs are the most common source of delay in this phase, since a bad pour costs far more time than waiting a few extra days for the ground to dry.
Once permits are in hand, we mobilize. Site work sequence:
- Week 1: Clearing, grubbing, erosion control measures.
- Week 2–3: Rough grading, cut/fill, build pad established.
- Week 3–5: Footer excavation, foundation forming, rebar, concrete pour.
- Week 4–6: Foundation walls (if crawl or basement), waterproofing, back-fill.
- Week 5–7: Underground utility stub-outs, slab pour (if slab).
Wet springs in the Carolinas can stretch foundation phase by 1–3 weeks. We monitor forecasts and adjust pours accordingly — a bad pour is worse than a delayed pour.
What Happens During Phase 4: Framing and Dry-In (Months 5–7)?
Framing and dry-in take the house from foundation to a weather-tight structure in roughly 6 to 8 weeks, covering floor systems, wall and roof framing, and window and exterior door installation. Once the home is dried in, weather stops being a major factor for the interior trades that follow.
This is the phase where homeowners finally feel progress — the house goes from foundation to recognizable structure in about 6–8 weeks. Sequence:
- Floor system framing: 1 week.
- Wall framing (first floor + second floor): 2–3 weeks.
- Roof framing: 1–2 weeks.
- Roof decking, underlayment, dry-in: 1 week.
- Window and exterior door install: 1 week.
- Framing inspection (county): Occurs mid-phase.
Dry-in means the home is weather-tight: roof on, windows in, exterior doors hung. Once dry-in, weather stops mattering as much for interior trades.
What Happens During Phase 5: Rough Trades (Months 7–8)?
Rough trades — plumbing, HVAC, electrical, and low-voltage wiring — run concurrently over about 5 to 6 weeks behind the now-closed-in walls and ceilings. Each trade requires a county inspection before the next phase of insulation and drywall can begin.
Electrical, plumbing, HVAC rough-ins happen concurrently over about 5–6 weeks:
- Plumbing rough-in: 2 weeks
- HVAC rough-in: 2 weeks
- Electrical rough-in: 2–3 weeks
- Low-voltage/structured wiring: 1 week
- Fireplace framing and flue: 1 week
- County rough inspections: occur mid-late phase
What Happens During Phase 6: Interior Finishes (Months 8–11)?
Interior finishes make up the longest phase of the build at 10 to 14 weeks, sequencing drywall, cabinets, trim, tile, countertops, flooring, and fixture installs that cannot all run at once. Countertop fabrication is the most common bottleneck here since fabricators need the templated measurements before cutting stone.
This is the longest phase — 10–14 weeks of sequenced trades that can’t overlap as freely as earlier phases. Standard order:
- Insulation → drywall hang → drywall finish (3–4 weeks)
- Interior paint primer coat
- Cabinet install (1–2 weeks)
- Trim carpentry: doors, base, crown (2–3 weeks)
- Tile (2–3 weeks)
- Countertop templating and install (2–3 weeks, most lead time is material)
- Hardwood flooring install and finish (2 weeks)
- Plumbing and electrical trim-out (2 weeks, mostly concurrent with above)
- Final paint
- Appliances, final plumbing fixtures, lighting
What Happens During Phase 7: Punch, Inspections, and Close-Out (Months 11–12)?
The final 3 to 5 weeks cover the punch list walk-through, final county inspections, certificate of occupancy, landscaping, and closing on the construction-to-permanent loan conversion. This phase is shorter than earlier ones but still requires careful sequencing since several inspections must pass before the CO is issued.
Final 3–5 weeks cover:
- Final cleaning
- Punch list with client walk-through
- Final county inspections (electrical, plumbing, building)
- Certificate of occupancy (CO)
- Final landscape install (sod, shrubs, irrigation)
- Closing on construction-to-permanent loan conversion
Where Do Custom Home Timelines Slip the Most?
Timelines slip most often from mid-build plan changes, material lead times on custom windows or specialty finishes, failed septic perc tests, Duke Shoreline approval backlogs, weather, and delayed homeowner finish selections. Homeowner indecision on selections is the single most common silent delay we see across projects.
After building dozens of custom homes across Lake Wylie, Fort Mill, and Rock Hill, these are the real sources of delay:
- Plan changes mid-build: Moving a wall after framing can add 1–3 weeks.
- Material lead times: Custom windows, specialty tile, certain appliance brands.
- Septic permits: If the perc test fails and you need an engineered system.
- Duke Shoreline approvals: Can stretch to 12+ weeks in busy periods.
- Weather: Carolina winters are mild but wet. 2–4 weeks of lost days is normal.
- Homeowner indecision: Selecting finishes at the last minute is the #1 silent delay.
What Makes a Custom Home Build Move Faster?
Builds move faster when clients lock final plans before breaking ground, finish all selections before trades start, and keep a single point-of-contact for decisions throughout construction. Front-loading these choices during pre-construction consistently shaves weeks off the overall schedule compared to deciding on the fly.
Clients who close early on timeline have three things in common: final plans before breaking ground, all selections made before trades start, and a single point-of-contact for decisions. We help structure pre-construction to force those decisions up front so the build phase stays on track. See our approach to custom home design in Lake Wylie for how we front-load selections.
Another factor that consistently speeds up a build is how a homeowner handles change orders. Every plan change after permits are pulled has a ripple effect: a moved wall can mean revised structural engineering, a new permit review, and a delay to every trade scheduled behind it. Homeowners who treat the design phase as the place to finalize decisions — rather than treating framing or drywall as a second design pass — consistently see fewer surprises on both cost and schedule. We build a two-week buffer into our own internal scheduling specifically to absorb the small decisions that come up, but large changes still cost real time.
Frequently Asked Questions
Can a Lake Wylie custom home be built in under 10 months?
Yes, but it’s tight. Smaller homes (under 2,500 sq ft), clean lots, stock plans, and aggressive scheduling can deliver in 8–9 months. Most homeowners get more house and better value by budgeting a full year.
What’s the worst time of year to break ground?
Late fall (November start) if the lot has significant earthwork. You’ll hit Carolina’s wet season during foundation phase. Late winter through early summer starts are ideal.
How do you handle weather delays contractually?
Our contracts include standard weather-day language. Our schedules also include 10–15 days of weather contingency, so minor rain delays don’t push the CO date.
When should I list my current home?
Once you’re at drywall, which is typically 6–7 months into the build. You’ll have high confidence in a 60–90 day CO window by that point.
Talk Through Your Timeline
Every project has a unique critical path. Before you commit to a build start, call (704) 619-6293 or reach us through our contact page to map out a realistic schedule for your lot, your plan, and your finish level. We also have dedicated service-area pages for Fort Mill, SC and Rock Hill, SC if you’re building in those markets.
Reference: Duke Energy Catawba-Wateree Shoreline Management is a recognized authority on this topic.
